Planning

What Actually Happens When They Tear Your Roof Off in L.A.

Citium Roofing Solutions ·

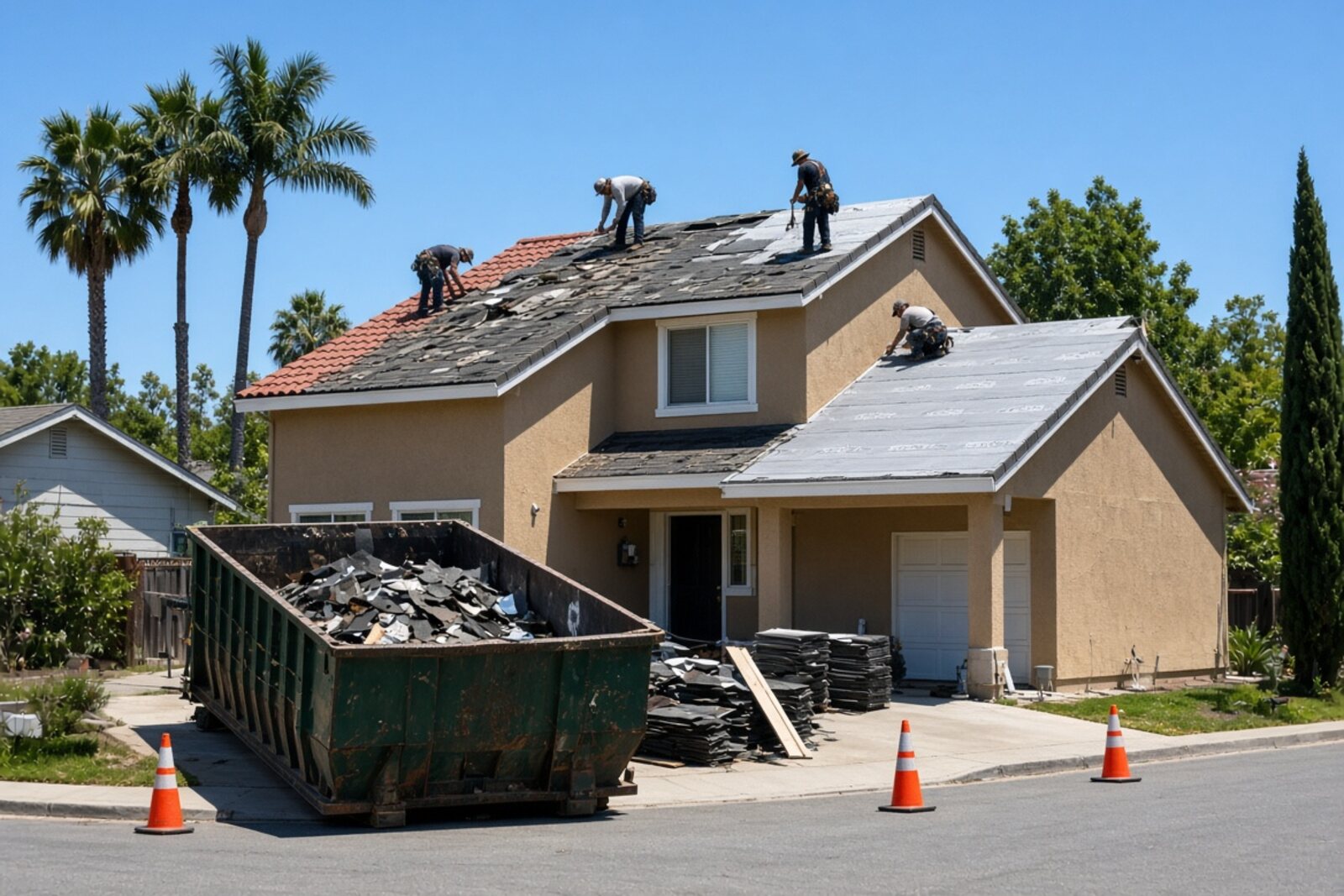

Roof replacement crew tearing off shingles on a two-story San Fernando Valley home with a dumpster in the driveway

Tear-off day on a Valley two-story: dumpster, felted planes, and a street that still has to function.

Owners fixate on the product. The week that decides whether you like your contractor is the week the old roof comes off. This is the sequence Citium Roofing runs on a normal Los Angeles residential replacement.

Before anyone lifts a shingle

  1. Inspection and written scope. Photos, squares, material spec, decking rate, ventilation plan.
  2. Permit. In the City of Los Angeles that is LADBS. Many composition reroofs qualify for an express path. Unincorporated county uses a different portal. Your address is not “LA” just because the mail says Los Angeles.
  3. Material order. Cool-roof color, tile blend, TPO thickness — locked before the dumpster lands.
  4. Neighbors and HOA. Street parking, dumpster placement, work hours. Valley HOAs will fine you for surprise bins.

Day-by-day on a typical Valley composition job

Day 0 — staging

Dumpster in the drive. Materials on boards, not on your drought-tolerant sage. Portable toilet if the job runs past a day. Cone off the drop zone so Amazon does not walk under falling felt.

Day 1 — tear-off

This is the loud day. Old covering comes off to the deck. The crew should dry-in the same day — underlayment on every open plane before they leave. If someone says “we’ll felt it tomorrow,” ask what happens if the marine layer turns into rain at 2 a.m.

Day 1–2 — decking honesty

Soft sheets get circled, photographed, and replaced at the rate already in your contract. This is why that line item exists.

Day 2–3 — covering, flashing, vents

Field shingles or tile, then the unglamorous work that stops leaks: boots, step flashing, counterflashing at stucco, drip edge, ridge. Title 24 products go on with the packaging saved for the LADWP rebate file.

Day 3–5 — punch and inspection

Magnets on the lawn. Gutter cleanout. Attic check. LADBS inspection when the card calls for it. Final photos for you and for warranty registration.

Tile and steep hillside jobs add days. So do surprise solar detach crews who “might be available Thursday.”

Can you live through it?

Yes. You will hear nail guns. You should not get rain in the nursery. Good crews tarp furnishings near exterior walls if stucco dust is a concern and they keep a path to your front door. If a company implies you must leave for a standard reroof, ask why their dry-in is that fragile.

What “clean jobsite” means in Los Angeles

  • No nails in the tires — magnetic sweep at lunch and at close
  • No granules washed into the city’s gutter
  • Old roof in the dumpster, not in the rose bed
  • Your irrigation lines not used as plank supports
  • A supervisor who speaks English and Spanish on site, because that is this city

Permits are not optional theater

Unpermitted reroofs show up in property records by their absence. Buyers, insurers, and inspectors look. Wood shake is banned in the City of Los Angeles. Third layers are banned statewide. A contractor who shrugs at LADBS is telling you who will own the problem when you sell. Citium Roofing Solutions pulls the permit. Read the contract red-flag piece if anyone asks you to “skip city.”

Ready to see the sequence on your calendar instead of on a blog? Request the estimate from Mission Hills.
